How to Integrate Risk Registers in Scrum Teams Without Resistance
You’ve been assigned to lead a Scrum team that’s delivering mission-critical software. Your organization requires a risk register, but when you mention it in your first team meeting, you’re met with crossed arms and frowns.
“That’s waterfall thinking. We’re Agile,” says one developer. “Risk registers are just bureaucratic overhead,” adds another.
This scenario plays out in countless organizations where traditional project management practices meet Agile methodologies. The development team considers the risk register a “predictive process” that contradicts their Scrum mindset. Meanwhile, you’re caught between organizational requirements and team resistance.
Sound familiar? You’re not alone.
The root of this conflict isn’t about tools or processes—it’s about perception and knowledge gaps. Your team isn’t resistant to managing risks; they’re resistant to what they perceive as outdated, bureaucratic documentation that adds no value to their sprint work.
In this guide, you’ll discover how to bridge this gap not by forcing compliance, but through coaching your team to see the risk register as what it truly is: a powerful enabler of Agile values that can prevent sprint derailments and enhance predictability. We’ll transform the risk register from a source of friction to a catalyst for team success.
Why the Resistance? Unpacking the “Anti-Risk Register” Mindset
Before you can overcome resistance, you need to understand its origins. Why do Scrum teams often push back against risk registers?
The Knowledge Gap
According to discussions in project management communities, the primary reason for resistance is simply that “the team doesn’t know this”. Many developers have never been properly introduced to risk management concepts or have only seen them implemented poorly.
Cultural Misalignment
Risk registers can feel like artifacts of command-and-control management, clashing with Agile’s collaborative values. According to research on Agile transformations, teams fear losing autonomy when faced with what they perceive as top-down processes.
The Bureaucracy Perception
When a team has embraced Agile’s principle of “simplicity—the art of maximizing the amount of work not done,” a risk register can appear to be unnecessary administrative overhead that distracts from delivering value.
Comfort in Existing Practices
Teams comfortable with their Scrum rituals may see the introduction of a “PMP-style” tool as a threat to their established workflow or even as a sign the organization is retreating from its Agile commitment.
Interestingly, many of the challenges Scrum teams regularly face—such as mid-sprint emergencies, unavailable Product Owners, or stakeholder access issues—are precisely the kinds of risks a well-maintained register could help anticipate and mitigate. The irony is that these common Scrum challenges often derail sprints precisely because they weren’t identified as risks early enough.
Reframing the Risk Register as an Agile Enabler
The key to integration lies in reframing how the team perceives the risk register—not as a static document created at project inception and then forgotten, but as a dynamic, living artifact that supports Scrum’s core values.
What Exactly Is a Risk Register?
At its simplest, a risk register is “a tool for identifying potential risks in project execution.” (Source: ProjectManager.com). Note the word “tool”—not process, not bureaucracy, but a tool that serves the team.
From Predictive to Adaptive
In traditional project management, risk registers might be created upfront and revisited infrequently. In Agile, they become living documents that evolve sprint by sprint. As ISACA notes, “Agile’s iterative approach allows for adaptive risk management, where risks are tackled incrementally during sprints.”
This aligns perfectly with the Agile principle of responding to change, as risk management is fundamentally about anticipating change. It’s worth noting that according to the Standish Group’s Chaos Study, “Agile projects are three times more likely to succeed than Waterfall projects,” and effective risk management contributes significantly to this success rate.
Lightweight and Value-Focused

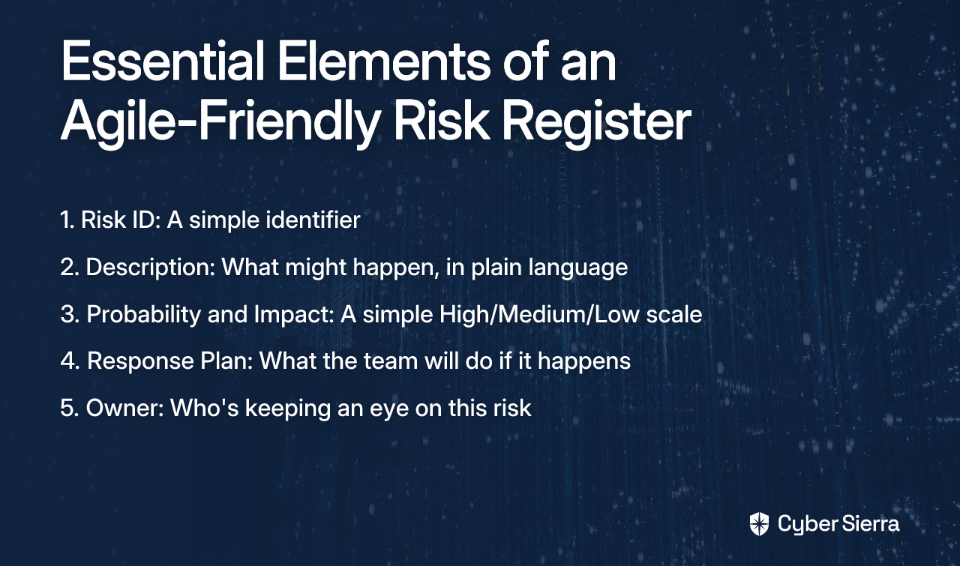

An Agile-friendly risk register doesn’t need every field from a traditional template. It can be streamlined to include only:
That’s it—no complexity, no bureaucracy, just information the team needs to work more effectively.
The Coaching Playbook: Weaving Risk Management into Scrum Events
The most successful integrations of risk management into Scrum don’t create new meetings or processes; they weave risk activities into existing Scrum events. Here’s how:
1. During Backlog Refinement & Sprint Planning
As the team discusses Product Backlog Items (PBIs), the Scrum Master or Project Manager can ask simple questions:
- “What might slow us down on this story?”
- “Are there any external dependencies we’re assuming will be ready?”
- “What technical unknowns could impact our delivery?”
These questions naturally surface risks without ever using “risk management” terminology that might trigger resistance. Add identified risks to your lightweight register.
2. Risk Assessment in Sprint Planning
Once the Sprint Backlog is formed, take 15 minutes to quickly review risks associated with the selected PBIs. Ask the team to rank them based on probability and impact (High/Medium/Low). This tells you where to focus your attention without extensive analysis.
3. Making Risk Responses Actionable
For high-priority risks, convert the response plan into a concrete task in the Sprint Backlog. For example:
Risk: “The new payment API might not handle our expected transaction volume.”
Sprint Task: “Create a load-testing script to verify API performance under peak conditions.”
This approach transforms risk management from an abstract concept to tangible work that delivers value. Assign an owner to each key risk—someone who’ll keep an eye on warning signs.
4. Monitoring Throughout the Sprint
- Daily Scrum: When appropriate, risks can be mentioned as impediments. “The risk of a delayed server deployment is now high; I’m coordinating with DevOps.”
- Sprint Review: When demonstrating the increment, briefly mention how risks were handled. “We successfully mitigated the performance risk by implementing caching, which allowed us to complete the feature on time.”
- Sprint Retrospective: This is your key feedback loop. Ask: “How did our risk identification help this sprint? Were there surprises we should have anticipated? How can we improve our risk awareness?”
By embedding risk discussions into these existing ceremonies, you make risk management a natural part of the team’s rhythm rather than an imposed process.
Practical Strategies for Overcoming Resistance
Even with a thoughtfully designed approach, you may still encounter resistance. Here are strategies for fostering adoption:
1. Co-create the Process
Don’t impose a template. Instead, involve the team in designing their own lightweight risk register. Ask what information they think would be valuable to track and what format would be least intrusive. When the team builds the tool, they’re more likely to use it.
2. Educate Through Benefits, Not Compliance
Host a short workshop that focuses on the “why” before the “how.” Frame the benefits in terms the team values:
- Fewer sprint disruptions
- More predictable delivery
- Reduced technical debt from emergency fixes
- Greater stakeholder confidence
Use real examples from past sprints where early risk identification could have prevented problems. Listen empathetically to concerns and address them honestly.
3. Start Small and Celebrate Wins
Begin with a simple approach—perhaps just identifying the top three risks for each sprint. When the team successfully mitigates a risk, celebrate it: “Great job identifying that dependency risk early—it saved us from a major delay!” These positive experiences build momentum.
4. Lead by Example
As the project manager or Scrum Master, demonstrate vulnerability by openly discussing risks you see without blame or judgment. When leaders model risk awareness as a positive behavior, teams are more likely to follow suit.
5. Connect to Agile Values
Consistently tie risk management back to Agile principles:
- Transparency: The risk register makes potential obstacles visible to all.
- Inspection: Regular risk reviews help the team inspect their assumptions.
- Adaptation: Early risk identification allows for proactive adaptation.
From Resilient Code to Resilient Teams
Successfully integrating risk registers into Scrum isn’t about forcing compliance with organizational requirements. It’s about coaching your team to see risk management as an enabler of Agile values that helps them deliver more predictably and with fewer disruptions.
Remember, as the Reddit discussion highlighted, “you have to teach/coach/mentor the team in the purpose of a risk register.” This coaching approach transforms resistance into understanding and eventually into ownership.
When implemented thoughtfully, risk management doesn’t contradict Scrum—it enhances it. Your team will become not just creators of resilient code, but a more resilient, confident, and successful Scrum team capable of navigating uncertainty with ease.
By bridging the gap between traditional project management wisdom and Agile practices, you create a stronger, more adaptable approach that draws from the best of both worlds.
Frequently Asked Questions
What is an Agile risk register?
An Agile risk register is a simple, dynamic tool used by Scrum teams to identify, track, and manage potential issues that could impact their sprints. Unlike traditional, static registers, an Agile version is a living document that evolves with the project, helping the team adapt to change and prevent disruptions.
Why do Scrum teams often resist using a risk register?
Scrum teams often resist risk registers because they perceive them as bureaucratic, non-Agile “waterfall” tools that contradict their collaborative and autonomous culture. This resistance typically stems from a knowledge gap about modern risk practices, a fear of losing autonomy, or the perception that it is unnecessary administrative overhead that distracts from delivering value.
How can I introduce a risk register without disrupting my team’s workflow?
The best way to introduce a risk register is to seamlessly integrate risk discussions into your existing Scrum events. During Sprint Planning, ask what could slow the team down. In the Sprint Retrospective, discuss what surprises could have been anticipated. By weaving these conversations into the team’s natural rhythm and co-creating a simple register, you make risk management a supportive tool rather than an imposed process.
What should an Agile-friendly risk register include?
An Agile-friendly risk register should be lightweight and focus only on essential, actionable information. A simple and effective format includes just five key fields: a unique Risk ID, a clear Description of the potential issue, a simple Probability and Impact rating (e.g., High/Medium/Low), a concrete Response Plan, and an Owner responsible for monitoring the risk.
Isn’t risk management just waterfall thinking?
No, while traditional risk management can be a rigid, upfront process, Agile risk management is fundamentally different. In a waterfall model, risk registers are often created once and rarely updated. In an Agile context, risk management is an adaptive and continuous activity. The register is a living document that is reviewed and updated iteratively, aligning perfectly with the Agile principle of responding to change.
Related Articles
5 Questions to Ask to Transform Your Risk Register Meetings
Learn 5 essential questions for effective risk register meetings. Transform compliance-focused sessions into strategic risk management discussions with actionable threat modeling insights.
How to Structure Your Risk Register Without Losing Control Visibility
Learn how to structure your GRC risk register to maintain visibility of vulnerabilities and control deficiencies while creating a clear, strategic view of organizational risks.
Your Risk Register is a Data Dump. Here’s How to Fix It.
Transform your risk register from a static vulnerability dump into a strategic asset. Learn practical steps for implementing threat modeling, compensating controls, and business-aligned risk management.
